Overcoming the 4,000-Mile Blindspot: How On-Ground Verification Saved a Delayed Overseas Boiler Project
.png)
Project Overview
When an Indian engineering conglomerate outsourced the manufacturing of three critical waste-heat recovery boilers to a vendor in China, cross-border progress reporting quickly emerged as an operational red flag.
Production fell behind schedule, and the 4,000-mile distance made direct oversight difficult. Time-zone disconnects and severe language barriers further prevented the project team in India from verifying reported progress or enforcing corrective actions at the Chinese facility.

Our team deployed a China-based partner to get eyes on the shop floor, document production risks, and enforce structured vendor follow-ups. To scale this visibility, Venwiz managed these execution gaps via OrderPulse; applying AI predictive insights and domain expertise to protect delivery timelines well ahead of deadlines.
Curious how ground-level verification turned a 4,000-mile blindspot into a proactive recovery? The sections below outline the on-ground execution strategy.
Project Challenges
Initial updates from the Chinese vendor failed to provide verifiable proof of workshop progress. Granular on-ground review revealed 5 core execution challenges threatening the Indian conglomerate's delivery timeline:
- Limited Shop-Floor Visibility: Distance left the Indian project team with near-zero visibility into actual daily shop-floor operations in China. Reported updates lacked documentary evidence of actual progress, masking outstanding work and actual production velocity.
- Unverified Delays Risked Timelines: Manufacturing delays had already compromised the baseline timeline across all three boiler units, leaving the project team uncertain if completion dates were achievable.
- Language & Communication Barriers: Technical discussions regarding project bottlenecks, design adjustments, and recovery plans were challenging due to language differences.
- Manpower Constraints: A single production crew was split across multiple boiler units, creating a severe resource bottleneck that prevented parallel manufacturing.
- Design & Procurement Misalignment: Late design changes to nozzle connections required extended technical discussions. These changes directly impacted the procurement of forged nozzles; a key material input for boiler manufacturing.
Venwiz Solution
Venwiz addressed these cross-border gaps through OrderPulse, powered by the Milestone Management OS (MMOS) engine, to coordinate manufacturing oversight directly at the vendor’s facility in China.
A China-based local partner provided on-ground verification, while the central execution team tracked progress, reviewed reported status, and coordinated structured follow-up between the Indian conglomerate and the Chinese vendor.

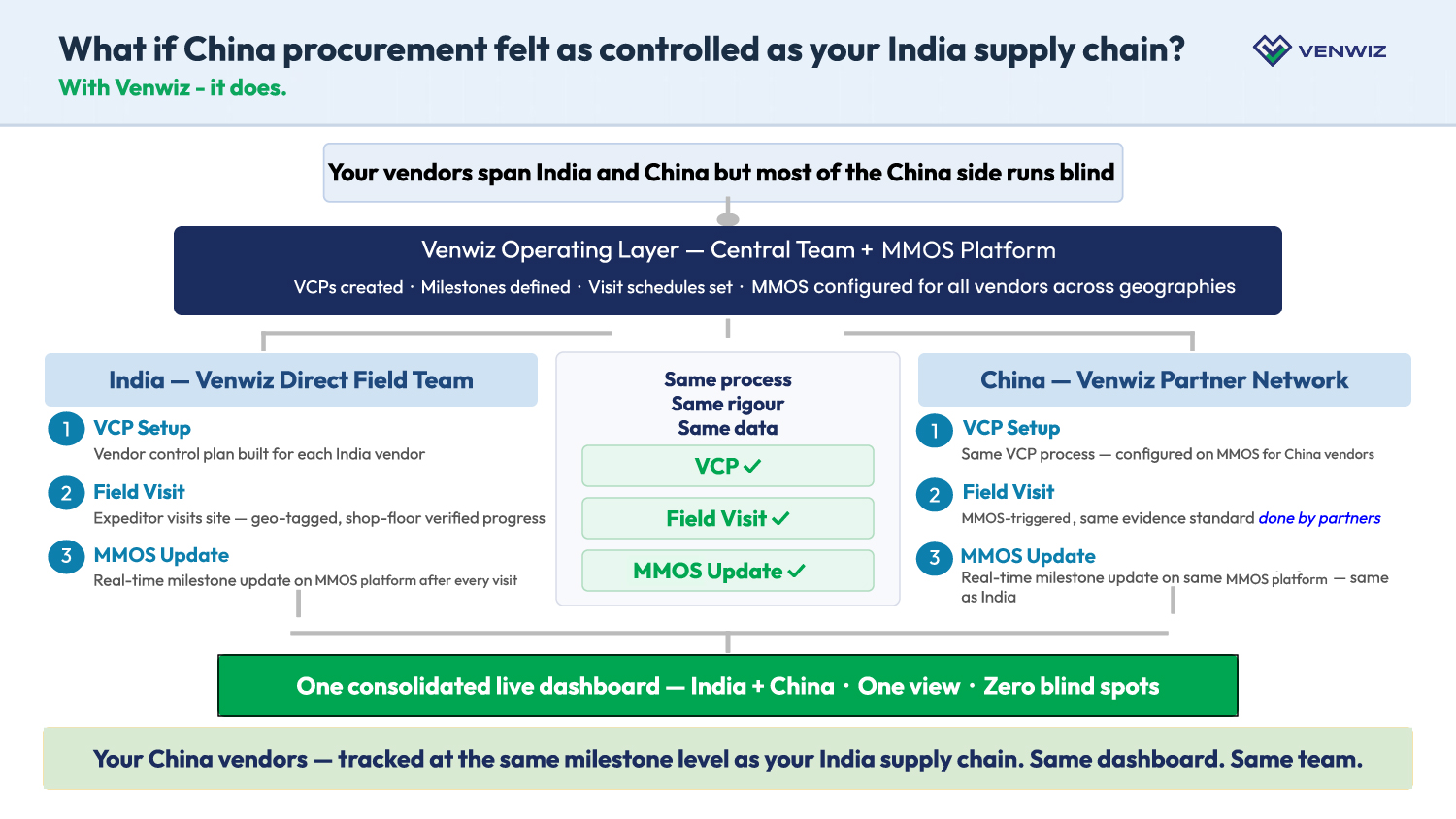

The graphic below illustrates how on-ground verification and structured tracking bridged the coordination gap between the manufacturing facility in China and the project team in India:

Rather than accepting unverified supplier promises across borders, Venwiz’s team actively intervened through three structured actions:
1. Shop-Floor Verification & Baseline Reconciliation
Venwiz’s China-based partner visited the vendor’s facility to review manufacturing activities and identify outstanding work across all three boiler units. The audit revealed that while engineering and purchasing were 100% complete, nozzle welding remained in progress on all units due to delayed processing for additional forgings and insufficient manpower.
.jpg)
On-ground inspection captured through the expeditor’s progress report confirmed a -19% manufacturing deviation (31% actual vs. 50% planned), driving an overall project variance of -11.4%:
2. Cross-Border Milestone Tracking
Through the Milestone Management OS (MMOS) platform the Venwiz team were able to bring real-time structure to cross-border tracking. While OrderPulse served as the central solution for predictive visibility and milestone analytics, MMOS provided granular activity planning, delay reporting, and end-to-end issue tracking. This enabled both the Indian project leadership and Chinese vendor teams to transparently review milestones, escalations, action items, and outcomes in real time.
3. Production De-bottlenecking & Executive Escalation
Venwiz directly escalated manufacturing delays and resource constraints to the Chinese vendor’s senior management. The team negotiated a recovery plan requiring the vendor to assign dedicated, parallel production crews to each boiler unit rather than splitting a single team. This strategic intervention eliminated the manpower bottleneck and successfully pulled back the manufacturing target ahead of the required dispatch timeline.

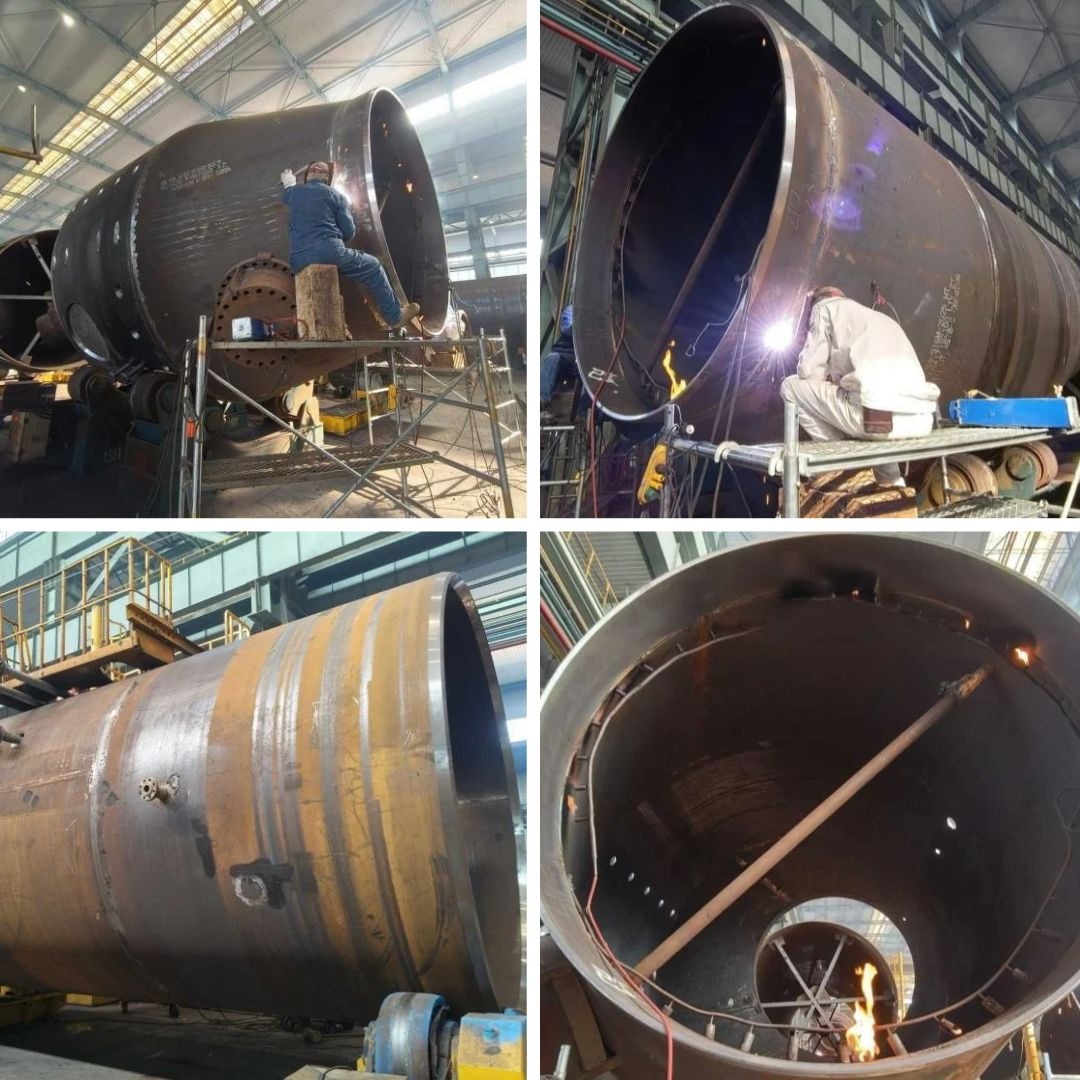

The images below capture the on-ground manufacturing activities and shop-floor conditions reviewed by the local team in China:

Project Impact
By replacing unverified distant status updates with active on-ground verification and structured milestone tracking, Venwiz successfully turned a slipping schedule into a controlled, on-time delivery.
The table below summarizes the operational turnaround across key project dimensions:

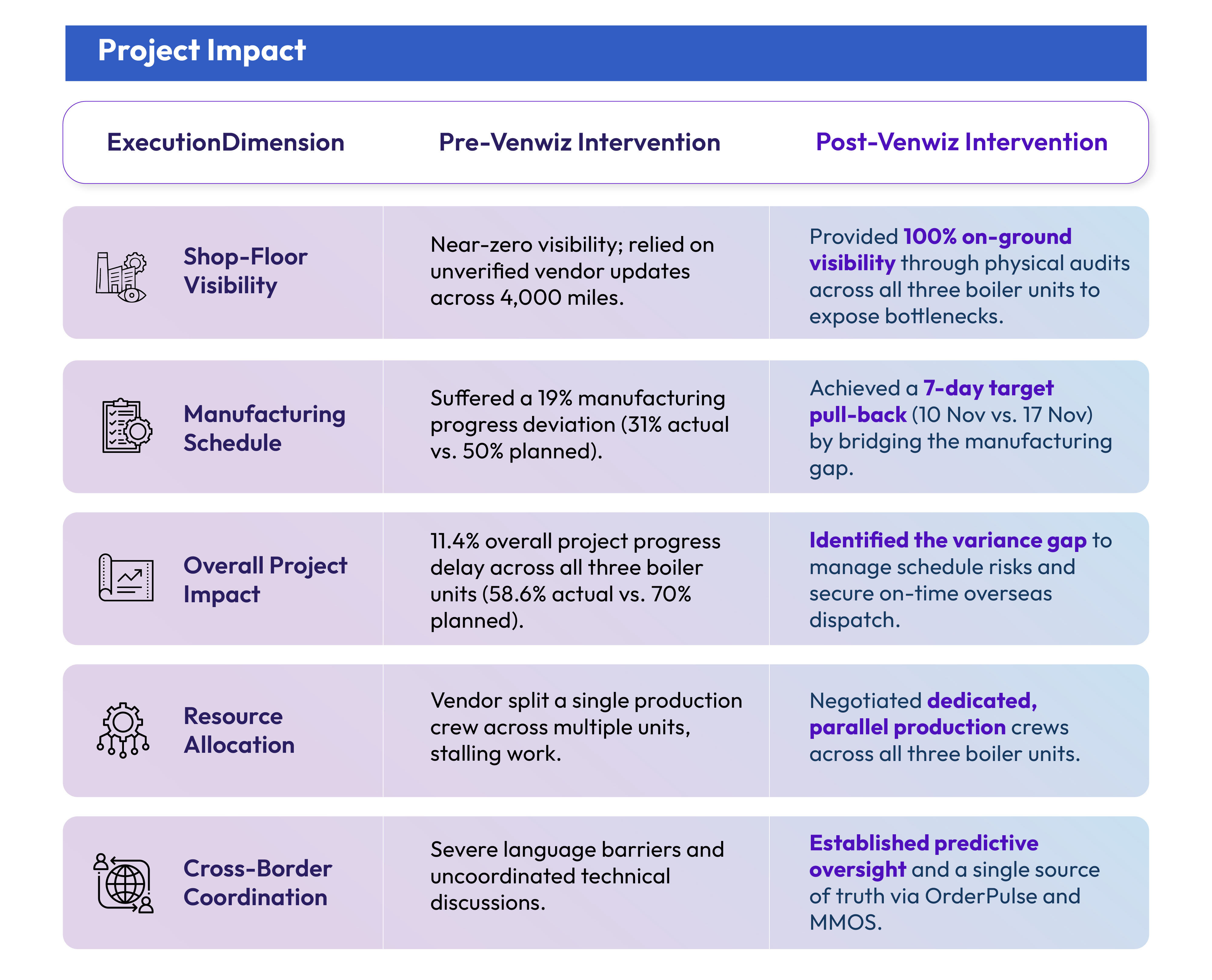

.jpg)
Beyond these operational metrics, the true value of this ground-level control is reflected in the client's own experience:

The Bigger Picture: Why Localized Visibility Matters
Managing overseas manufacturing requires more than faith in supplier status reports—it demands verified shop-floor data, structured milestone tracking, and timely escalation of production bottlenecks.
The boiler project illustrates the value of combining local on-ground presence with intelligent execution platforms. By identifying labor bottlenecks, resolving procurement holds, and enforcing parallel execution, project teams can turn severe cross-border delays into proactive, zero-blindspot deliveries.
Intelligent Procurement & Post-PO Execution Control turns potential multi-month overseas delays and communication barriers into predictable, on-time project outcomes.
Need better visibility into overseas manufacturing? Contact Venwiz to learn how OrderPulse supports manufacturing progress tracking and delivery oversight. →
